Making a significant contribution to India’s growth agenda as the country gets back on the move despite navigating another phase of rising COVID-19 cases, are several infrastructure and development projects that will bolster manufacturing and industrial growth. And to ensure that these projects progress on-schedule, leading integrated logistics services providers like Allcargo Logistics create logistics magic with engineering excellence and ingenious Project Logistics services.
Moving complex machinery and critical equipment across the length and breadth of the country is not an easy task. It requires thorough planning, detailed documentation, several permissions – all backed by a relentless commitment to safety and timely delivery.
More often than not, these projects involve multiple associates, and a knack of working collaboratively to enhance efficiencies across every stage of the factory-to-foundation is of utmost importance. That’s precisely why customers across industries rely on trusted partners like Allcargo, who have over two decades of experience and expertise in Project Logistics solutions.
It is no wonder then, that when one of India’s longest cargoes of 96 metres, weighing more than 1000 MT along with several other equipment had to be moved from Mumbai (Maharashtra) and Hazira (Gujarat) to Paradip (Odisha), the team at Allcargo was called on to deliver innovative solutions and impeccable execution.
Multimodal cargo movement at multiple stages
“For all of us at Allcargo, moving one of India’s longest cargoes from Gujarat, all the way to Odisha is nothing short of spectacular. Our team truly stepped up its game as it coordinated movements from two origins – Mumbai and Hazira – to Paradip port in Odisha. Since this was the first time a cargo of these proportions was being received at the destination, the learning curve was steep and rife with challenges, requiring the team to be agile and flexible to adapt along the way. But living up to our values of collaboration, innovation and customer centricity, we made it happen, with zero compromise on safety or quality”, said Rahul Rai, Business Head of Project & Engineering Division, Allcargo Logistics.

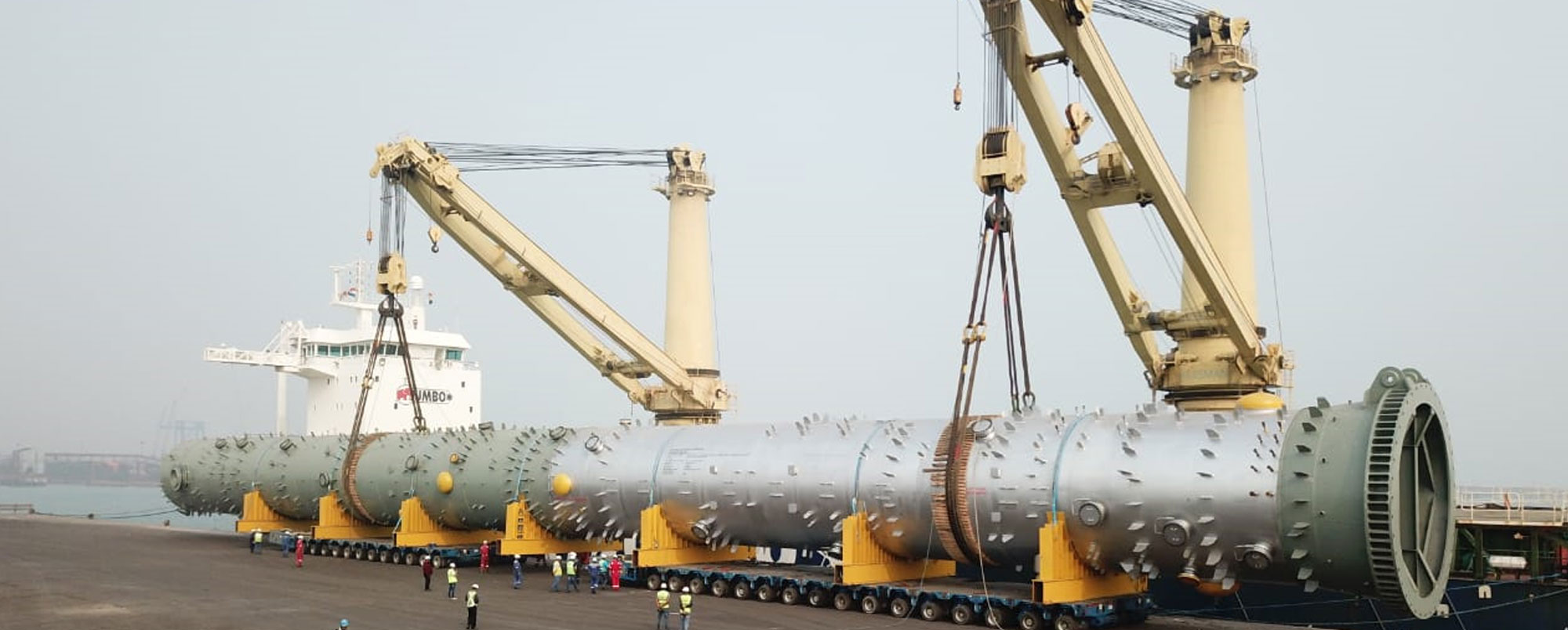

The cargo being moved comprised of a wash tower, deethylenizer, EO reactor being transported from Hazira in Gujarat and a reactor steam drum from Mumbai in Maharashtra. With the longest piece of equipment being 96 metres, the total weight of the cargo being moved was more than 3400 MT. From both origin points, a series of multimodal transportation milestones dotted the voyage to Paradip port in Odisha.
The trajectory of the cargo that moved from Hazira was:
• Road transportation from the factory in Hazira to the jetty
• Roll-On on to the barge at the jetty
• Barge movement from the jetty to the Hazira port (alongside vessel)
• Vessel voyage from the Hazira port to Paradip (PICT) port
• Underhook receiving from the vessel on SPMT (Self-Propelled Modular Transporter)
• Road transportation from PICT to the project site
For the cargo being transported from Mumbai, the journey comprised of:
• Road transportation from the factory to the jetty
• Roll-On on to the barge at the jetty
• Barge movement from the jetty to the Hazira port (alongside vessel)
• Vessel voyage from Hazira port to Paradip (PICT) port
• Underhook receiving from the vessel on SPMT
- After thorough research and analysis, a suitable location was identified at the origin’s yard where such long packages could be fabricated.
- A 180-degree rotation of the 96 metre package was carried out on the south side of the yard to bring it to a suitable orientation for loading on to the vessel.
- A Ro-Ro ramp suitable for such a long piece of cargo was designed to carry out the Roll-on operation.
- Additional vigilance and precautions were taken to maintain the crane lifting radius while lifting the cargo using vessel gears, which proved to be quite a challenge.
- At the Paradip port, a PICT boundary wall was demolished to ensure safe passage while coming out of the port premises.
- Civil work and modifications were also carried out at the project site in Odisha for safe manoeuvring of the cargo.
- A bypass was prepared at the Sandkhurd village for safe passage of the cargo.
